SITE WORK'S BEFORE THE START OF LIFT WORK
- POINTS NEED TO BE DO BY CLIENT :
•ARRENGE THE SCAFFOLDING MATERIAL
•LOCKABLE ROOM FOR MATERIAL AT 1STOR GROUND FLOOR
•ALL TYPE OF CIVIL WORK
•GIVE PROPER POWER SUPPLY – SINGEL OR THREE PHASE WITH EARTHING AND LIGHT ARREGMENT AT EVERY FLOOR
•ALL TYPE OF FABRICATION WORK
📩 Please download or print out this pdf for detailed informationTYPE OF WORK DESCRIPTION REFRENCE PUT THE HOOK A 16 MM ROD AT CENTER OF RCC TOP ROOF DURING THE LIFT PERIOD. (U TYPE ) - THE BARS OF NOMINAL DIAMETER 16 MM USED IN COMPRESSION FOR AN RCC WORK CONSISTS OF M30 GRADE CONCRETE FOR WHICH DESIGN BOND STRESS IS 1.5 N/MM2.

LIFT SHAFT SHOULD BE CLEAN. - NO EXTRA RCC
- NO EXTRA IRON
- NO EXTRA PVC PIPE
- PIT CLEAN

LIFT PIT SHOULD BE CLEAN AND WATERPROOF AND PIT DEPTH SHOULD BE 1600 MM / 1800MM / 2000MM. - DO PCC
- WATERPROOFING
- PIT CLEAN

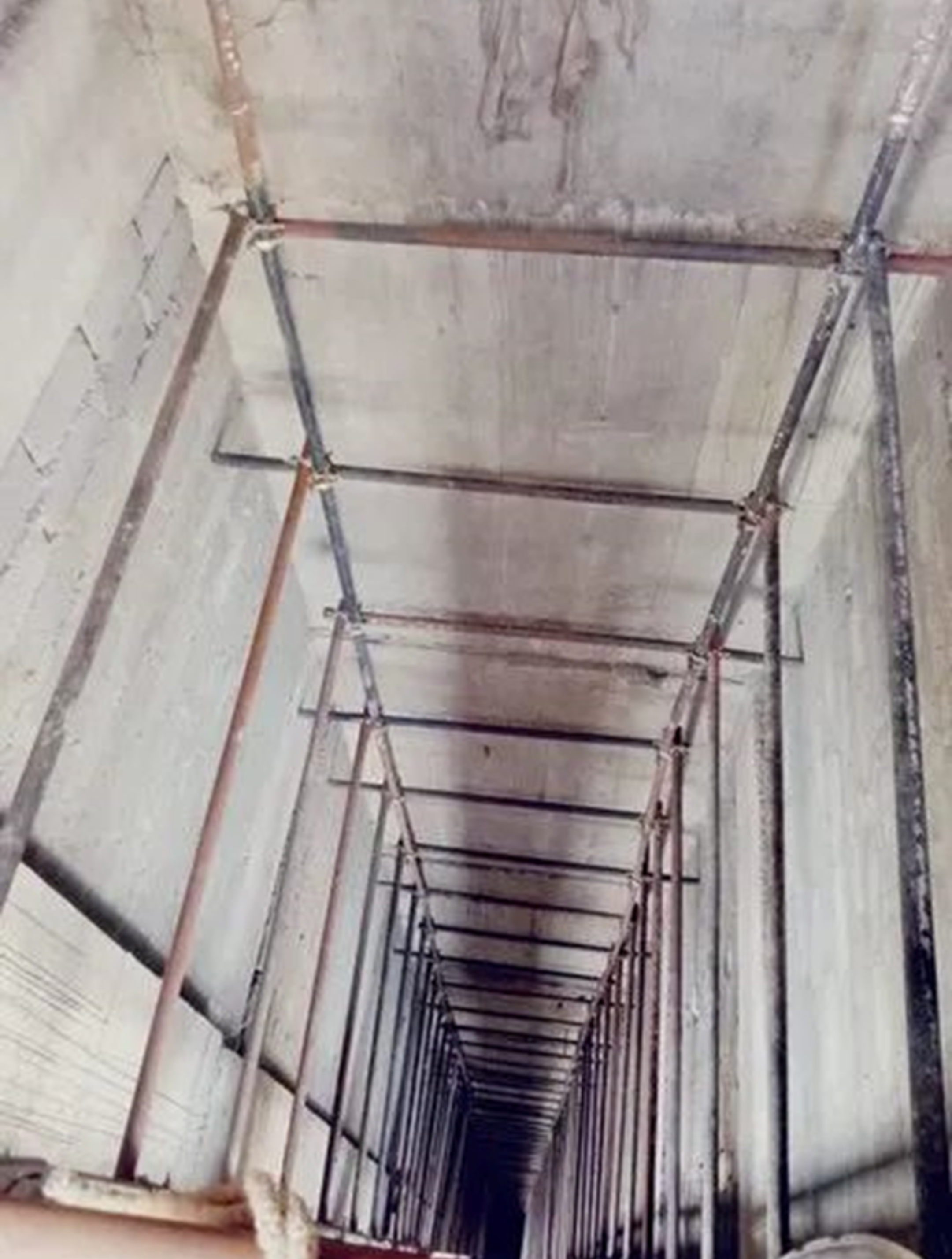

AFTER THAT STARTING THE WORK OF SCAFFOLDING.( IT’S TAKE AROUND 2 TO 3 DAYS) - PROVIDE SCAFFOLDING MATERIAL

DO CONSTRUCTION OF SIDE WALL AT EVERY FLOOR AS PER PLUMB OR ERECTOR INSTRUCTION FOR DOOR FRAME SUPPORT - CONSTRUCTION OF SIDE WALL

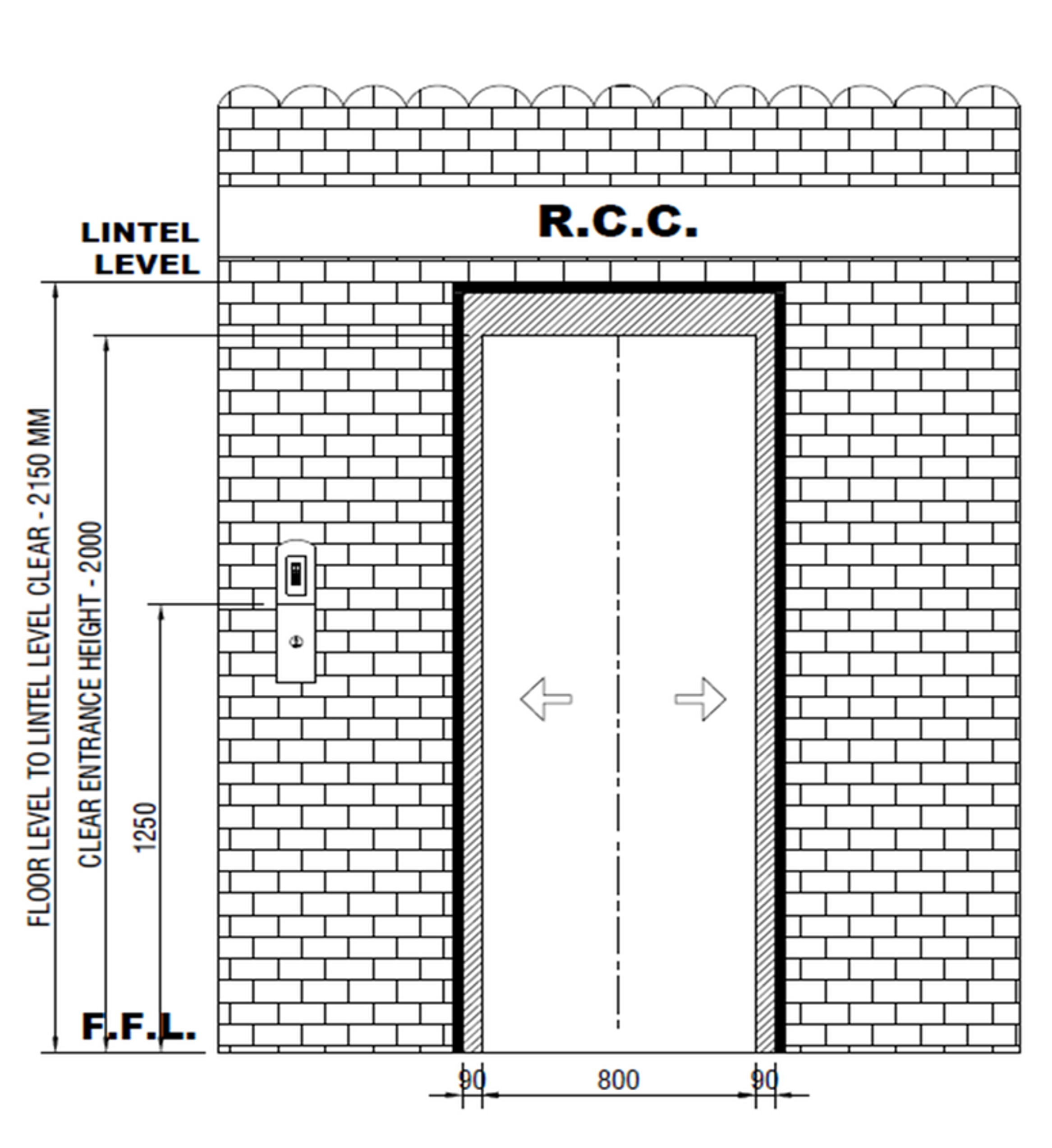

- PUT THE RCC LINTEL AT 2150MM TO THE F.F.L.
- FINISH WITH PLASTER
- DO WHITE WASH OR COLOR IN WHOLE SHAFT

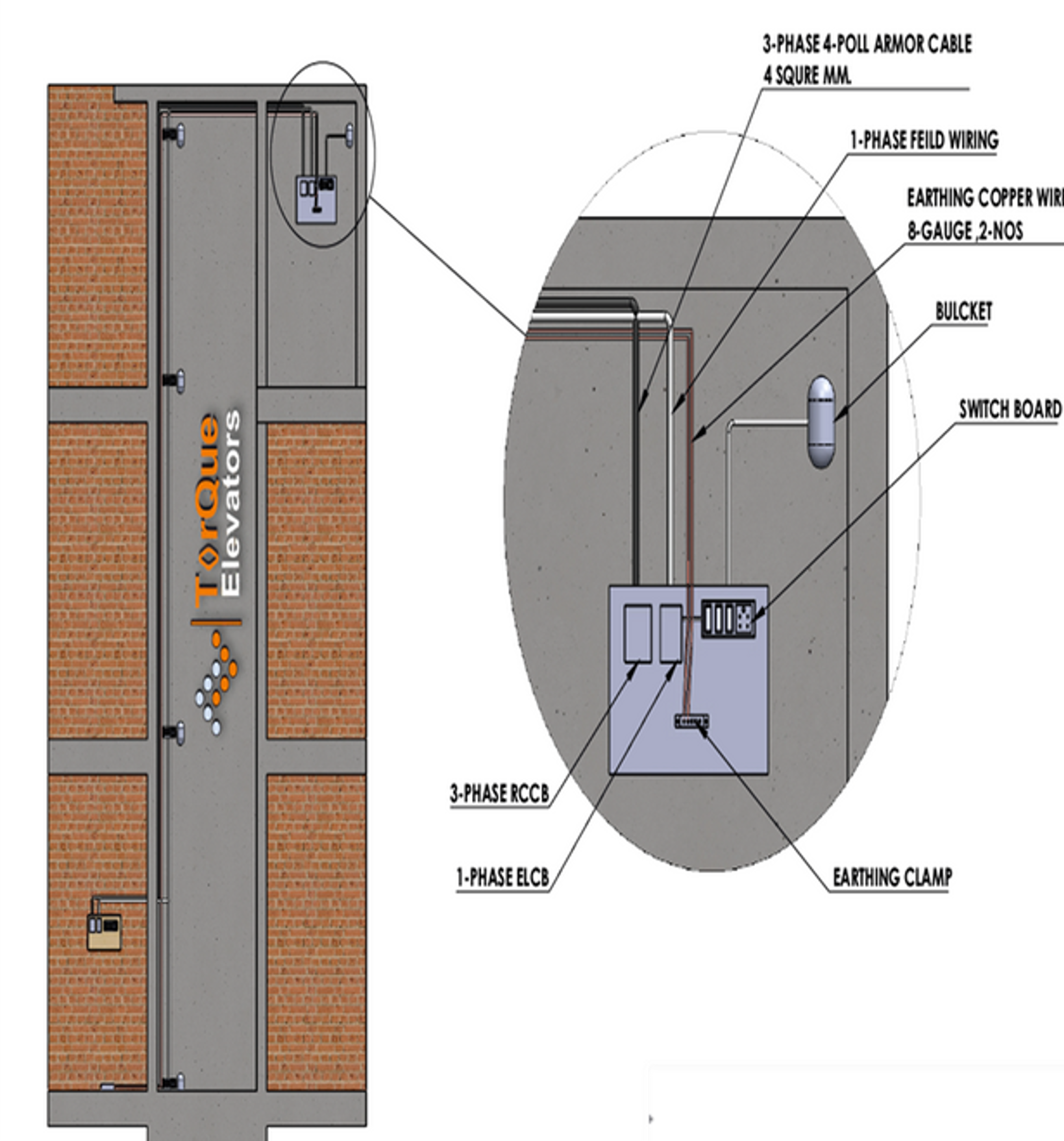

MANDATORY INTRODUCTION OF RCCB-32A / 64A (30MA) OF THREE PHASE AND SINGLE PHASE. - HAVING TO PROVIDE THE SAME IN THE LIFT LICENSE PROCESS
- HE SITE SHOULD RECEIVE 420 TO 440 VOLTS IN THREE PHASES, NOT LESS THAN AND NOT MORE THAN
- PIT CLEAN
- 📩 CLICK TO GET MORE INFO

IF THERE IS A MACHINE ROOM, THE IRON STAIRCASE TO ENTER THE MACHINE ROOM SHOULD BE 3 FEET WIDE AND THE STEPS SHOULD BE 4 INCHES IN SIZE AND THE STAIRS SHOULD BE HANDLED AND PAINTED. - PCC AT FLOORING IN MACHINE ROOM
- PLASTER ALL SIDE OF WALL
- DO PAINT OR WHITE WASH
- 2 NOS CROSS VENTILATION WINDOWS (1.5 x 1.5 mtr )
- PAINTED AND LOCKED DOOR (minimum 5 ft x 5 ft)
- PUT MOSQUITE GRILL ON WINDOW
